Database validation is an important step in ensuring that you have quality data in your historical database. I've talked before about the importance of collecting project data and what you can do with your own data, but it all hinges on having thoroughly vetted project history.
Although it's nice to have every tab in SLIM-DataManager filled out, we really only need three key pieces of information to calculate PI:
These fields can be thought of as the desired minimum information needed, but even if one is missing, you may not want to delete the project from the database. A project that is missing effort data, for instance, will not have a PI but could be used to query a subset of projects for average duration by size. Likewise, a project with no size will not have a PI, but does contain effort and duration information that could be useful for calculating the average time to market for a division. However, if possible, it is a good idea to fill out at least these three fields.

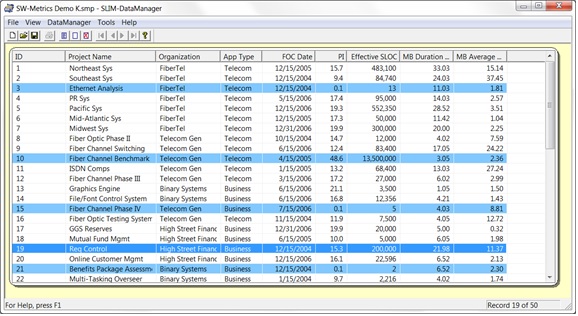

The main question to ask yourself in the validation process is: does anything jump out? We're looking for potential data entry errors or perhaps just a-typical projects. A good starting point is to use the Validation feature in SLIM-DataManager. Simply go to File|Maintenance|Validate, and SLIM-DataManager will check for the following project details:
If you have out of sequence phases or other inconsistences, SLIM-DataManager will highlight those projects in blue. If you hover over them, a tool tip will appear which will tell you what you need to check out.

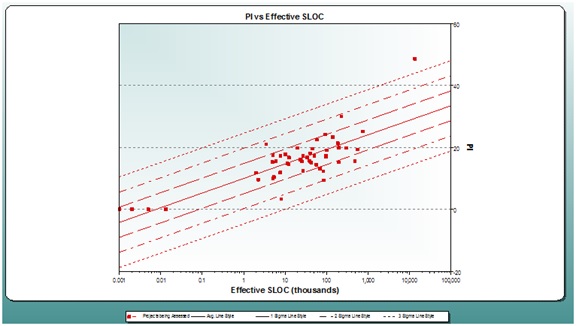

Another method of identifying extreme data values is to sort the columns for PI, peak staff, or other metrics in the Project List view in SLIM-DataManager or to examine the data in a scatter plot in SLIM-Metrics. If you suspect a value is an outlier, display it against trends for both the data set and the comparable QSM application domain. If it is outside of three standard deviations from the mean, it is an outlier and should probably be excluded from the trend, though you may want to retain the project. In the image above, notice the project sitting outside of three standard deviations at roughly 10,000K SLOC. This project is a-typical for the PI vs. SLOC trend, but for other trends, it might be typical. Instead of deleting the project from your database, you can remove the project from the curve fit by right-clicking on the project and selecting Special Project, then go to Metrics|Exclude Special Projects from Curve Fit, then recreate your trends.
If your data is going into a corporate database, it would be a good idea to use keywords and other descriptive data for querying and sorting. Often times, the data collector won't fill in that information because he or she knows what the project is about, but in a corporate setting, that information can be priceless. For example, if your organization uses Agile and waterfall methodologies, it might be helpful to tag those projects using keywords to help easily identify them.
In my experience validating data for QSM's historical database, here are a few extra tips:
These are just a few ways you can verify the quality of the data in your database. The database validation process does take considerable time, but in the end, it's worth knowing that the data you use for trend lines, benchmarking, and to tune estimates is as accurate as possible.
